How to Negotiate Shorter Lead Times for Limited-Edition Kids’ Sunglasses?

0 Comentarios

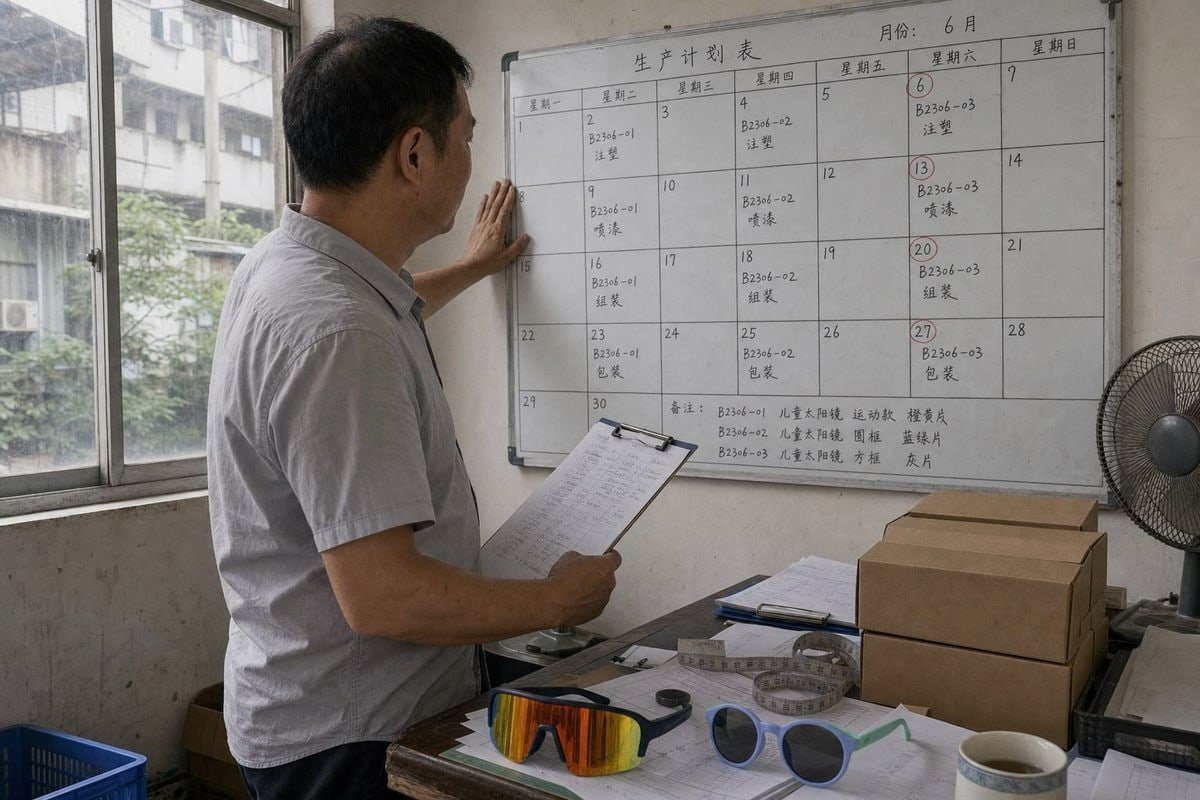

Negotiating shorter lead times for limited-edition kids' sunglasses production orders (ID#1)

Negotiating shorter lead times for limited-edition kids’ sunglasses is a question I hear weekly at our Taizhou factory. A missed launch window can kill a seasonal drop — and the panic is real.

To negotiate shorter lead times for limited-edition kids’ sunglasses, trade something the factory values — early booking, existing frame styles, finalized artwork, or predictable repeat orders — for queue priority. Break the quoted lead time into stages, compress only the safe stages, and lock milestone dates in writing.

Lead time is not one number. It is a chain of steps. Once you see each step clearly, you know exactly where to push and where to leave things alone. Let me walk you through how we handle this with our own buyers.

What factors actually determine how fast a factory can produce my limited-edition kids' sunglasses order?

Last spring, a European buyer asked me why her 3,000-piece order needed 45 days when a competitor quoted 25. The honest answer sat inside our production schedule, not our willingness.

Factory speed depends on five stages: raw material procurement, mold or tooling readiness, sampling and approval rounds, queue position in batch production scheduling, and quality control inspections before shipment. Custom molds and out-of-stock materials add the most time; existing styles and stock materials remove it.

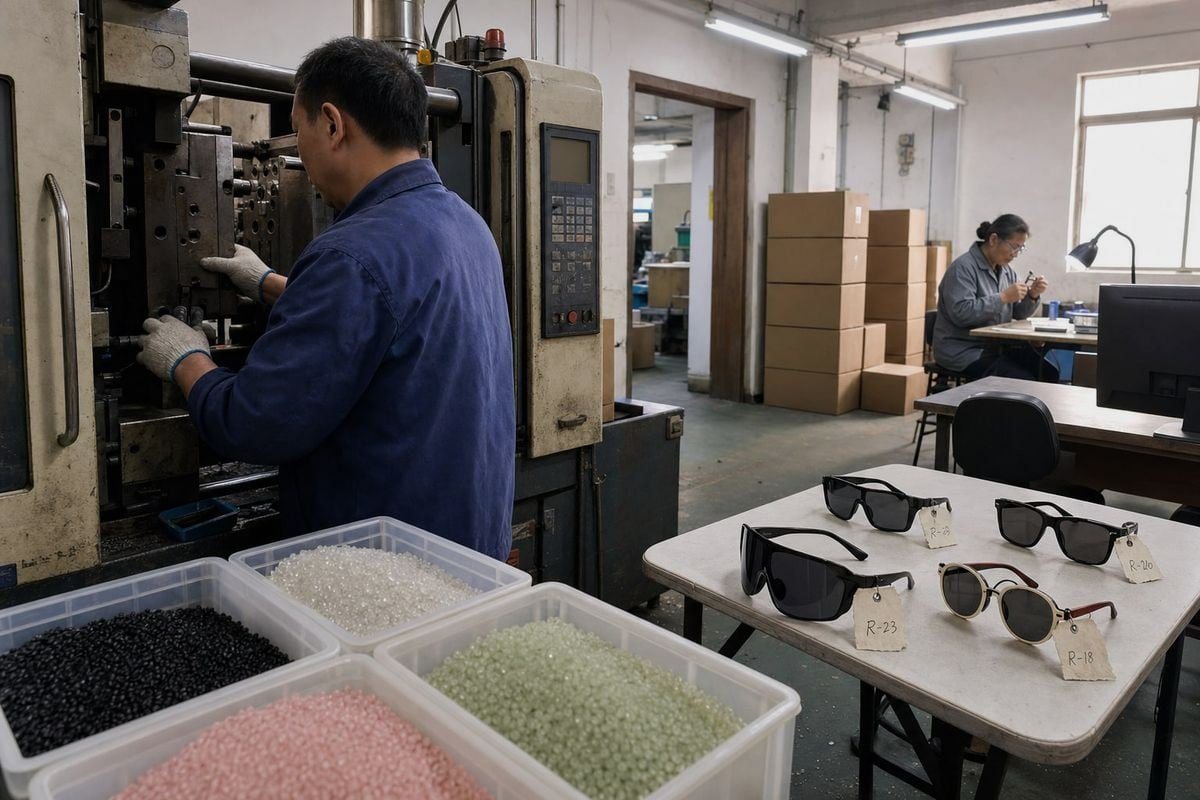

Factory stages affecting production speed for limited-edition kids' sunglasses orders (ID#2)

When we quote a production cycle time at our workshop, we are really adding up several smaller clocks. Buyers who understand each clock negotiate far better than buyers who argue over the total.

The five clocks inside every quoted lead time

First, raw material procurement. Safety-compliant kids' materials like TPEE y TR90 1 are not always sitting on a shelf. If our supplier needs to run a batch of a specific color masterbatch, that alone can add two to four weeks. Second, tooling. A brand-new custom mold 2 typically needs 45–60 days before a single frame exists. Third, sampling. Every revision round adds roughly a week, sometimes two, once courier time is included. Fourth, the factory queue. Our manufacturing capacity planning 3 fills up fast in Q3 and Q4, so an order placed in August waits behind orders placed in June. Fifth, quality control inspections and packing, which we never rush for children's products.

Lead-time stage Typical duration Can it be compressed safely?
Raw material procurement 15–30 days Yes, with stock colors or pre-booked material
Custom mold / tooling 45–60 days Yes, by using existing molds
Sampling and approvals 7–21 days Yes, by limiting revision rounds
Batch production 15–25 days Partially, via queue priority
QC inspection and packing 3–7 días No — never skip for kids' eyewear

Notice something important. The two biggest blocks — materials and tooling — are also the two easiest to eliminate through smart product choices, not through pressure. That is the core insight behind every successful lead-time negotiation I have seen in fifteen years of eyewear work.

Quoted lead time is the sum of separate stages, and each stage can be negotiated individually Verdadero
Materials, tooling, sampling, production, and inspection each have their own clock, so identifying the specific bottleneck lets buyers compress the right stage instead of arguing over the total.
A factory’s quoted lead time is padded, so demanding a 50% cut is a reasonable opening move Falso
Most of the timeline is consumed by physical constraints like material procurement and mold machining; demanding a miracle without offering anything in return usually just gets a polite refusal or a risky corner-cut.

Can choosing from existing frame styles help me skip mold development time and shorten my lead time?

The single biggest time-saver we offer buyers is our library of roughly 800 existing styles — from wraparound sport shields with mirrored gradient lenses to soft round two-tone frames for toddlers.

Yes. Choosing an existing frame style eliminates the 45–60 day custom tooling phase entirely, which is usually the largest single block in the schedule. You then customize colors, lenses, logos, and packaging on a proven mold, often cutting total lead time by half.

Using existing frame molds to skip tooling time and shorten sunglasses lead times (ID#3)

This is the open-mold approach, and for limited-edition drops it is almost always the right call. Think about what "limited edition" actually means to your customer. It means scarcity, a special colorway, a themed lens, distinctive packaging. It almost never means a frame silhouette nobody has molded before. Your buyers will not measure the mold; they will notice the vibrant orange-to-yellow mirrored shield lens or the periwinkle-and-mint two-tone combination.

A modular way to think about customization

We encourage buyers to treat the frame as a chassis and the limited-edition elements as swappable layers. The chassis — an existing TR90 frame with flexible TPEE temples — is already tooled, tested, and sized for children's faces. The edition layers are fast to change.

Customization element Added time on an existing mold Impact on "limited edition" feel
Custom frame color (stock masterbatch) 0–5 days Alta
Mirrored or gradient UV400 lens 3–7 días Muy alta
Printed or laser logo on temple 2–4 days Alta
Custom retail packaging 7–14 days (run in parallel) Muy alta
Brand-new custom mold 45–60 days Low — customers rarely notice

What about MOQ trade-offs?

Existing molds also help with Minimum Order Quantity (MOQ). A custom mold usually demands a higher MOQ to justify tooling cost. An open-mold style lets a boutique kids' label run a smaller, faster batch and protect its inventory turnover rate. For a first limited drop, that lower risk matters as much as the speed. One Australian buyer of ours launched a holiday capsule in under five weeks this way — something no custom-tooled project could match.

Open-mold styles let limited editions launch in weeks instead of months Verdadero
Skipping custom tooling removes the 45–60 day mold phase, so customization shifts to fast elements like lens coatings, colors, logos, and packaging.
Using an existing factory mold means your sunglasses will look generic and hurt the brand Falso
Consumers respond to colorways, lens finishes, branding, and packaging — not mold geometry; a well-executed edition on a proven frame reads as fully original at retail.

How should I plan my order timeline and communicate with my supplier to avoid last-minute delays?

A painful lesson from our early exporting years: a buyer approved samples on time, then changed the packaging dieline mid-production. The two-week scramble that followed taught us to fix milestones in writing.

Plan backward from your launch date, add a 10–15 day buffer for QC, freight booking, and customs, and place the order about three months before peak season. Then agree written milestones — sample approval, material ready date, production start, inspection window, and latest ship date — with your supplier.

Planning order timelines and supplier communication to prevent kids' eyewear delays (ID#4)

Good supplier relationship management is mostly about removing ambiguity before production starts. In our experience exporting to more than twenty countries, delays rarely come from slow machines. They come from unanswered emails, late artwork, and unclear expectations.

A practical timeline, working backward

  1. Fix your launch date and subtract shipping time, including customs clearance.
  2. Subtract a 10–15 day contingency buffer. This absorbs QC findings, vessel booking gaps 4, and port delays.
  3. Subtract production and inspection time from your supplier's quote.
  4. Subtract sampling time — and agree a fixed number of sample rounds up front, with change-order pricing defined for extras.
  5. The date you land on is your real order deadline. For back-to-school or holiday drops, that usually means booking roughly three months ahead of the busy season, before batch production scheduling fills the queue.

Communication habits that actually prevent delays

Send a zero-correction tech pack: finalized vector artwork, Pantone codes 5, lens specs, and packaging dielines in one complete package. Every missing file becomes an email loop, and every loop costs days. Ask your supplier which stage drives the schedule — "Is the 45 days production time, shipping time, or both?" — so you compress the right thing. Confirm whether materials are in stock before signing. And if the full order cannot land in time, negotiate a split shipment: air-freight 10–20% of priority SKUs immediately after inspection to hit the launch date, while the balance travels by sea. Expedited shipping options cost more per unit, but far less than a missed drop. Finally, put every milestone in the proforma invoice or contract. Written dates get protected; verbal dates get forgotten.

Will pushing for a shorter lead time affect the quality and safety of my children's eyewear?

Here is the trade-off I weigh on every rush order: we can compress queue time and paperwork, but we will not compress the safety gates that protect a child's face.

Only if you compress the wrong stages. Cutting queue time, tooling, and administrative loops is safe. Skipping quality control inspections, material testing, or safety compliance standards is not. The goal is the fastest reliable lead time — not the fastest possible one — at an acceptable landed cost.

Balancing fast lead times with safety and quality standards for children's eyewear (ID#5)

Some buyers worry that any negotiation for speed signals to the factory that quality is negotiable too. That fear is understandable, but it confuses two very different kinds of compression. Rushing often does increase defect rates — when the rush lands on production and inspection. That is a legitimate objection, and the answer is to direct the pressure elsewhere.

Safe cuts versus dangerous cuts

Where you save time Risk to quality and safety Our recommendation
Using existing molds and stock TPEE/TR90 material None — proven components Always acceptable
Fewer sampling rounds with a complete tech pack Low, if specs are final Acceptable with discipline
Paying for queue priority or reserved capacity Ninguno Acceptable if the math works
Compressing injection, assembly, or curing time High — dimensional and adhesion defects Refuse
Skipping pre-shipment inspection or lab testing Very high — safety and compliance exposure Never accept

The gates we hold even on rush orders

For children's eyewear, our QC checklist covers frame dimensions, hinge screw torque, temple flexibility, lens optical tolerances, UV400 performance 6, and surface finish. Safety compliance standards for your destination market — testing for restricted substances 7, impact resistance, labeling — stay on the critical path no matter the deadline. A smart protection for buyers: hold back a small balance payment until final inspection is confirmed. It aligns incentives without slowing anything down.

Also run the math on speed itself. Calculate the cost per day of lead-time reduction. If an expedited slot costs 8% more but saves twelve days on a trend-sensitive drop, it is usually rational. If it saves three days on an evergreen restock, keep your money.

Queue position, tooling, and admin loops can be compressed without touching product safety Verdadero
These stages happen before or around physical production, so shortening them changes the schedule without changing how each frame is molded, assembled, or tested.
Skipping the pre-shipment inspection is a harmless way to save a few days on a tight launch Falso
For kids’ eyewear, an uninspected shipment risks safety failures, chargebacks, and recalls that cost far more than the days saved; inspection should stay fixed even on expedited orders.

Conclusión

Shorter lead times are earned, not demanded. Trade clarity and commitment for priority, cut tooling with existing styles, fix milestones in writing — and never compress safety.
